Projects

West Seattle Elementary

West Seattle Elementary School Addition Project

West Seattle Elementary has relocated to Schmitz Park School, 5000 SW Spokane Street, for the 2021-22 school year.

Timeline

graphic showing project phases; with we are here in construction box see timeline below
Learn what happens in each of these phases
  • Pre-design phase complete
  • Schematic design phase complete
  • Design development phase complete
  • Construction documents and permitting phase complete
  • Bid and award phase complete
  • Construction in progress
  • School reopens Fall 2022

Recent Progress

Updates are posted for the previous month the week after the monthly BEX and BTA Capital Levies Oversight Committee meetings. These meetings typically take place on the first Friday of each month.

Major Activity in October 2021

  • Completed demolition needed in the existing building
  • Completed the footings and stem walls for the addition and the entry canopy
  • Started installing underground plumbing and electrical for the addition
  • Continued work on plumbing, electrical, and steel stud framing in existing building
  • Began installing fire sprinklers in the existing building

Major Activity Planned for November 2021

  • Continue underground mechanical, electrical, plumbing, fire, and capillary break at addition
  • Pour the concrete slab for the addition
  • Install structural steel for the addition and existing building
  • Continue to work on steel stud framing and fire sprinkler in existing building

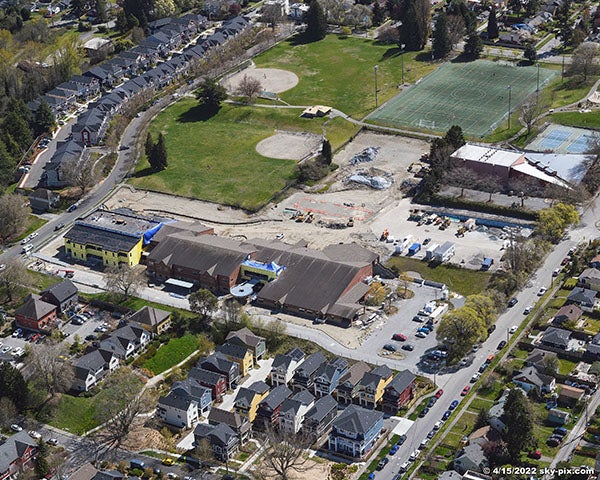

Live Webcam and Project Photos

site plan drawing showing school campus, school, and addition
Site plan with addition shown
a hill of dirt next to a brick building iwth a digging machine and some workers
Excavating for the new addition – Aug. 2021
inside of a large room with ceiling tiles removed and wires hanging down

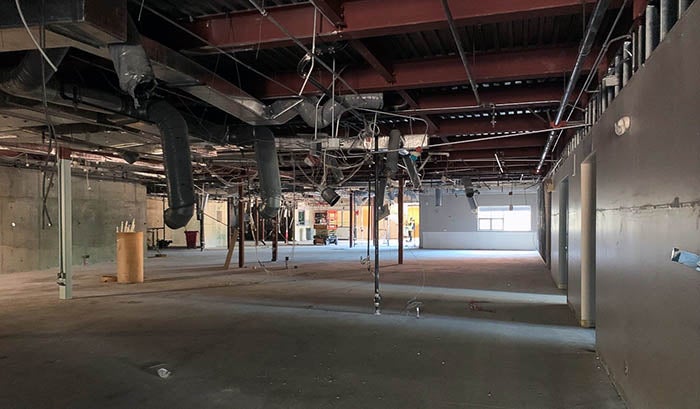

Selective demolition in the adminstration area and classrooms – Aug. 2021
a classroom with flooring removed

Demolition in one of the existing classrooms – Aug. 2021
a 2 story building has tarps in front of the entry and concrete forms set in an octagon

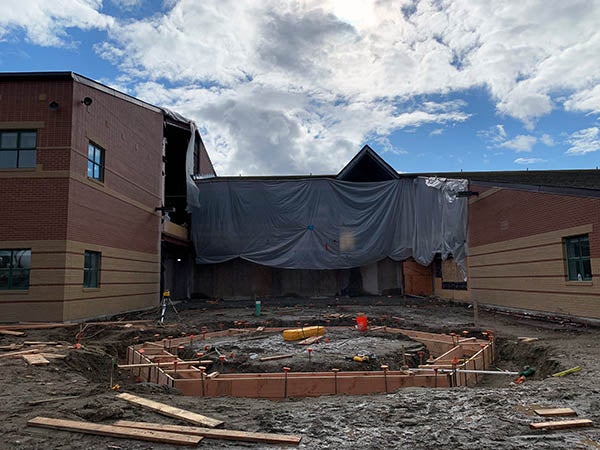

Footing framework for the entry addition and canopy – Oct. 2021
construction site with short wall forms that have new concrete in them
Concrete stem wall pour for east addition
tall wood forms for concrete are held up by bracing boards with a concrete pump int he background
Pouring stem walls for the classroom addition – Oct. 2021
a large rectangular hole has stepped sides
Digging in progress for storm water retention
trenches with pipes inside of a building
Installing underground plumbing in the existing building – Oct. 2021

About the Project

A new, approximately 20,000 square foot 2-story addition will provide 12 new classrooms and two learning commons to better support students’ academic success. A redesigned secure entrance will lead visitors through the administration office. The library will be relocated and expanded for more natural light and visibility. Minor modernization will be done to the existing 50,700 square foot school building. This includes new paint, carpet, and technology. The expanded school will provide permanent space for up to 500 students.

Mechanical systems will be upgraded. In addition, site improvements are planned for better pedestrian access and new play areas/fields.

Technology enhancements included in the BEX V capital levy are designed to provide equitable access to technology for high-need schools to support teaching and learning in meeting the needs of students. Equipment will include audio-visual systems that include classroom displays (projectors/screens), sound systems, document cameras, and devices to connect them. It will also provide technology equipment and services, such as computers, peripherals, printers, and other technology for teaching and learning.

A School Design Advisory Team (SDAT) that included the principal, staff, teachers, parents, and community members advised the school architect. This collaborative process resulted in an equitable, safe, and inspiring learning environment.

Design: Miller Hayashi Architects

Construction: Jody Miller Construction

Project Budget: $28.3M

Funding Sources:  Building Excellence V Capital Levy (BEX V), approved by Seattle voters in 2019 and a grant from the State of Washington

Contact Us

Let’s Talk Comments and Questions form

Project Manager: David L. Jackson, dljackson2@seattleschools.org, 206.252.0674

West Seattle Elementary School
6760 34th Ave SW

Interim site: Schmitz Park School
5000 SW Spokane Street

School Profile

School Website
